Students 'denied full college experience' by lack of apartments
A visualisation of BAMâs planned student apartments on Sullivanâs Quay in Cork, viewed from the Grand Parade.
The most recent computer-generated images of developer BAMâs lodged plans for large-scale purpose-built student accommodation (PBSA) in Cork city centre have brought the issue of student living back to the forefront.
They come amid continued delays from the Government on its student accommodation strategy which is causing widespread uncertainty for developers, colleges, and, above all, students.

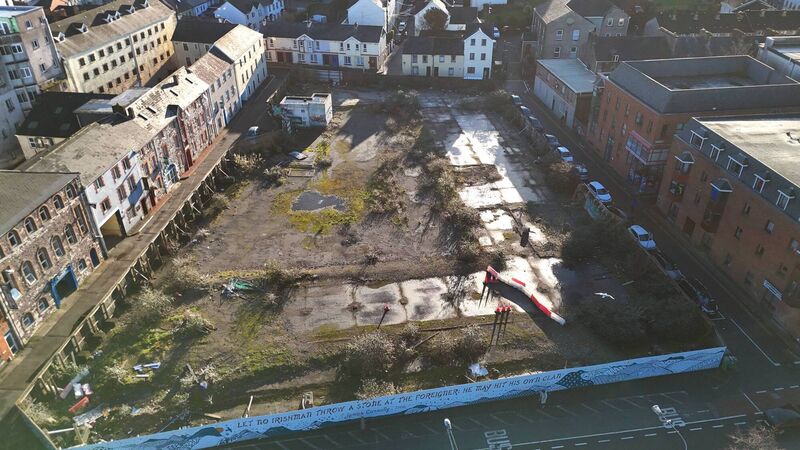

The latest plan to fill the void on Sullivanâs Quay following the demolition of the former tax office in 2019 is an ambitious student accommodation scheme spanning up to 11 storeys across two distinct blocks.
Developed by BAM, the buildings â if they make it through the planning process â would house just over 500 students across 67 apartments, ranging in size from four to eight bedrooms, with associated tenant amenity facilities such as a landscaped internal courtyard, a gym, an entertainment room, and a student hub.

What was initially earmarked for a 193-bed hotel just a stoneâs throw from Cork Cityâs Grand Parade, the site, at the centre of Cove St, Drinan St, Meade St, and Sullivanâs Quay, would also benefit from public realm upgrades as part of the plans.
This latest proposal for purpose-built student living follows almost a decade of high-level investment in the area, with major schemes spanning Cork City adding hundreds of beds for inbound students.
Another such scheme is the 420-bed Lee Point development on Corkâs South Main St.

This student apartment development was completed in 2020 by BAM and sits on the former Beamish & Crawford brewery site, where millions have also been invested into public realm upgrades.
Others include the 100,000sq ft BrĂłga House, the 50-apartment development complex located on Washington St.

Opened in 2022, the âŹ35m scheme, reaching heights of six storeys, mainly consists of eight-bed modular clusters, with individual ensuite double bedrooms and shared living and kitchen spaces.
The project was backed by the global real estate investment, development, and asset management firm Round Hill Capital (Ireland).
That firm also funded Ashlin House, the student complex on Bandon Rd.Â

The âŹ53m accommodation complex, located beside popular student pub Annie Macâs and directly across from Cissie Youngâs, comprises 554 beds and spans five storeys.
Shortly after construction was completed, Ashlin House was surpassed in size by the more recent Bottleworks student accommodation.

It is located at the site of the former Coca-Cola bottling plant on Carrigrohane Rd.Â
The 10-storey flagship development added a further 623 beds for Corkâs growing student population, making it one of the largest student-focused living schemes in Ireland.
Just down the road, the âŹ30m, four-block Crowâs Nest development in Victoria Cross opened in 2023 in time for that academic year.

Delayed by two years due to the pandemic, the development complex, known now for its distinctive Jenga block design, comprises 255 bedrooms.Â
Following on from the student accommodation boom of 2020-2024, which added around 2,000 extra beds for Cork Cityâs student population of about 35,000, just one student scheme is currently under construction.
Bellmount Developments, led by brothers Padraig and Seamus Kelleher, is currently working on the site of the former Kellehers Tyres service centre on Victoria Cross Rd.

The development, one of Bellmountâs many green-lit student accommodation schemes, was granted permission in 2020 and is set to provide 154 beds.
The developers also have planning permission for another strategic housing development, which aims to deliver 243 student beds at Wilton Rd in Victoria Cross.Â
Reaching a height of 10 storeys, the 40 student apartments in total will range in size from single-bed studio units to eight-bed apartments.
Bellmount Developments also has planning permission for another 136 student bed spaces down the road at Dennehyâs Cross.
The proposed development is in close proximity to both UCC and Munster Technological University.
It also secured permission for more than 200 student beds on the nearby Orchard Rd, which will see the currently vacant car dealership at the site be demolished and replaced with the purpose-built student accommodation scheme comprising 78 apartments across seven storeys.
Building apartments of any kind in Ireland is already a tricky business.Â
While they may be just what large cities need amid the current housing crisis, theyâre a highly regulated and higher-risk form of housing, with a large number of schemes only made viable by Government funding or international finance.
From a cost perspective, they are more expensive per unit to build and more vulnerable to delays due to the increased likelihood of appeals at the planning stage. They are also more exposed to changes in Government policy, and carry long-term operational obligations such as building management and fire-safety responsibilities.Â
These differ greatly from individual houses, where developers enjoy clean exits once they are delivered.
According to Dublin-based construction consultants Mitchell McDermott, the average cost per bed of building a student apartments is âŹ123,000.

On a square metre basis, a student apartment costs approximately âŹ4,000, which is significantly higher than the cost of standard apartments at âŹ2,600-âŹ3,000.
Construction Industry Federation housing and planning director Conor OâConnell, says:
Mr OâConnell says for standard, full-time residential apartments, viability usually relies on Government initiatives, such as the cost-rental scheme, or a deal from the Land Development Agency or an approved housing body.
âWhile there are subsidies available to make it happen, it is still very difficult,â Mr OâConnell notes.
âAnd worse, no such incentives exist for student accommodation schemes.â
Further research by Mitchell McDermott found that only 657 student beds were delivered in Ireland in 2025, reflecting a more than 50% drop in deliveries compared to the previous year. In 2026, the number of bed deliveries is forecasted to drop even further, with just 422 new beds estimated.
âStudent accommodation is in a very difficult place at the moment,â says Fergal Beacon, divisional director at Mitchell McDermott.
Across Ireland, there are currently 15,000 student beds that have been granted planning permission but have progressed to the construction stage, according to research by Mitchell McDermott.

Nationwide, just 2,146 beds are currently under construction, which Mr Beacon says is simply not enough to fulfil rising demand. A further 853 beds have been submitted for planning across the country, but these run the risk of joining the 15,000-bed delivery backlog already in place.
In Cork, there are currently just 154 beds under construction, those being one of the four schemes by Bellmount Development in the Victoria Cross area.Â
The other three developments by the Kelleher brothers join the list of schemes that have not started construction despite their positive planning bid, with the total number of beds in this category at 1,723. Meanwhile, just 174 beds are currently submitted for planning permission.

As of last week, there were 406 student accommodation beds in Cork under judicial review, in the case of the 50-apartment scheme at the site of the former St Josephâs Convent on Model Farm Rd since being quashed by the High Court.

The application has been returned to An CoimisiĂșn PleanĂĄla for further deliberation following the positive outcome for the nearby Woodlawn Residents Association.
They opposed the development, citing traffic concerns, unreliable public transport, adverse visual impacts, and issues relating to the schemeâs density.
Speaking on the review, Kieran Coughlan, managing director of Lyonshall, the developers of the proposed scheme, said the decision to revert the application would inevitably lead to further delays, âleaving students without accommodationâ.Â
âWe see the student horror stories every day across August and September as the new academic year approaches,â Mr Beacon adds.
"Everyone should have that student life that lets them transition into adulthood.â
Property developers across the country are currently awaiting the publication of the Governmentâs student accommodation strategy.Â
Initially scheduled to be released in mid-December, there remains no confirmed date for its release.
The strategy is estimated to target the delivery of 21,000 new-build private student beds between now and 2029. It also aims to increase the number of digs spaces for students to 10,000. How the final 10,000 beds will be delivered is yet to be determined.
âThis leaves developers in a very uncertain place,â Mr Beacon says.Â
"We have 15,000 student beds with planning permission that have not moved.Â
"People are waiting to see what is in this strategy before they act.
Given that the viability of student accommodation is largely reliant on international finance, which has become harder to secure in recent years, Mr Beacon says a stable regulatory framework is essential to ensure certainty for investors.

âThere are rent caps for student accommodation schemes currently in place until 2029, along with the maximum tenancy agreement for purpose-built student apartments of 41 weeks.
âWhile this is mostly fine for inner-city developments, which can be rented out on a short-term basis over the summer months, there is no demand for that in the suburbs, adding to the costs borne by developers." Mr Beacon added:Â
âWe have had significant construction cost inflation over the last number of years, and it doesnât seem to be going away. Weâre still forecasting cost increases of 3%-4%.
âConstruction will always be expensive, and more is needed from the Government to ensure purpose-built student accommodation will continue to be delivered.â
